How Long Does Automatic Gate Installation Actually Take?

A simple retrofit onto a sound existing gate can be hours. A new sliding gate with fresh electrical service is a multi-day project — and a UL 325 safety-testing step applies either way, with its own minimum sensor counts straight from the standard.

  • Reviewed Oct 17, 2026
  • Source: UL 325, ASTM F2200, City of Galveston
  • Sensor-count tool
Black metal sliding driveway gate with a solar-powered operator beside a paved drive

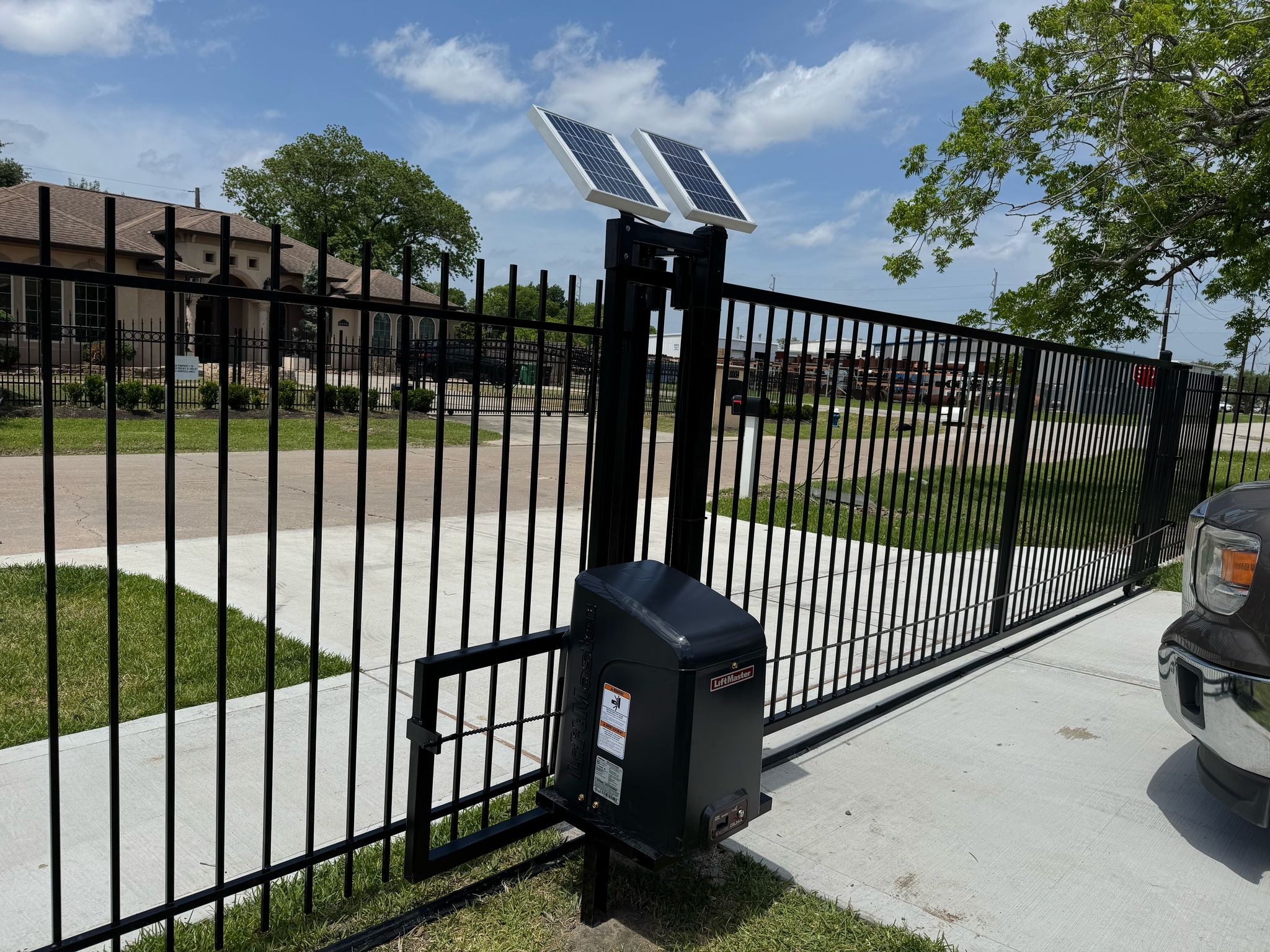

A sliding driveway gate with a solar-powered operator — the finished result of the sequence below.
The short answer

Automatic gate installation timelines vary widely: a retrofit of an existing, structurally sound swing gate can sometimes finish in hours, while a new sliding gate with fresh electrical service is usually multi-day. Two steps apply no matter which: if new posts are set, the concrete must cure before the operator is mounted, and every installation must pass UL 325 entrapment-protection testing — the City of Galveston has adopted the 2021 IRC Appendix AO, which requires automatic vehicular gates to comply with ASTM F2200 construction and UL 325-listed operators.

2 secMaximum time a UL 325-listed operator has to begin reversing after sensing an obstruction
2Independent entrapment-protection means required for most gate types, in each direction of travel (UL 325 Table 32.2)
6 ftMinimum distance activation controls must be installed from the gate, per UL 325
Ord. 23-012Galveston’s adoption of the 2021 IRC Appendix AO, which requires ASTM F2200 construction and UL 325-listed operators

Sources: DASMA TDS 353 (reprinting UL 325 Table 32.1/32.2); City of Galveston Ordinance 23-012 (2021 IRC Appendix AO); LiftMaster CSW24UL/CSL24UL operator manuals.

The typical project sequence

Most automatic gate installations move through the same general phases, whether it’s a small residential retrofit or a larger commercial entrance: a site visit to measure the opening and confirm power availability; gate fabrication or repair; posts set in concrete (if new); the operator mounted and wired; UL 325-required entrapment-protection sensors installed and tested; access control programmed; and a final full-cycle test.

A straightforward retrofit of an existing single swing gate can sometimes skip most of the early steps and move quickly. A new sliding gate installation with a fresh electrical run, safety sensors and access control from scratch is more often a multi-day project — there’s no single number that fits both.

Six-step flow diagram of an automatic gate installation: site visit and design, gate fabrication or repair, posts set and concrete cures, operator mounted and wired, entrapment sensors installed and tested, and access control plus final test — with the concrete-cure and safety-testing steps highlighted as the two that add real calendar time.THE TYPICAL AUTOMATIC GATE INSTALLATION SEQUENCE1. Site visit & designOpening, slope, power availability, swing vs. slide2. Gate fabrication or repairBuild new, or inspect/repair an existing gate and posts3. Posts set & concrete curesIf new posts are set, concrete must cure before the operator is mounted4. Operator mounted & wiredSwing arm, slide track/cantilever, or solar panel + battery5. Entrapment sensors installed & testedUL 325-required — not optional (see D-2)6. Access control & final testRemotes/keypad programmed; full open/close cycles confirmedTwo steps that addreal calendar timeConcrete curing beforethe operator is mounted,and UL 325 safety testingthat must pass before thegate is handed over.A simple retrofit onto a sound existing gate can skip straight to step 4.New electrical service or sliding-gate track work stretch this into days.
D-1
DrawingThe typical installation sequence
BasisMustang Fencing Services’ own process description, cross-checked against UL 325 (DASMA TDS 353) and LiftMaster operator manuals for the cure-time and testing steps
ScaleNot to scale
Steps 3 and 5 are where a calendar, not a crew, sets the pace — concrete needs time to cure, and UL 325 testing has to actually pass.

Why the safety-testing step isn’t optional

The City of Galveston adopted the 2021 International Residential Code’s Appendix AO (Automatic Vehicular Gates) via Ordinance No. 23-012, which requires that vehicular gates intended for automation be designed and built to ASTM F2200, and that the gate opener itself be listed to UL 325. That’s the code basis for why the testing step on the previous sheet is a real requirement, not an upsell.

UL 325 spells out specifics: after an operator senses an obstruction, it must begin reversing within 2 seconds and travel at least 2 inches. Every external sensor has to be monitored by the operator on every open/close cycle — if a sensor faults, the gate can’t run normally until it’s fixed. Activation controls (keypads, push buttons) must sit at least 6 ft from the gate to reduce reach-through risk, and at least two warning signs must be posted at the gate.

Table of UL 325 Table 32.2 minimum independent entrapment-protection means required for opening and closing, by gate operator category: horizontal slide gate 2 and 2, horizontal swing gate 2 and 2 with a footnote exception, vertical pivot gate 2 and 2, vertical lift gate 1 and 2, horizontal bifold gate 2 and 2.MINIMUM INDEPENDENT ENTRAPMENT-PROTECTION MEANS (UL 325 TABLE 32.2, VIA DASMA TDS 353)Gate operator categoryOpeningClosingHorizontal slide gate22Horizontal swing gate2*2*Vertical pivot gate22Vertical lift gate12Horizontal bifold gate22* Swing gates need 2 independent means in each direction with an entrapment zone; if one direction has none, thatside only needs 1 — the other direction still needs 2.Every sensor in this table must be monitored by the operator every cycle —a fault disables normal running until it’s fixed.
D-2
DrawingMinimum entrapment-protection means by gate type
BasisUL 325 Table 32.2, reprinted in DASMA TDS 353
ScaleNot to scale
This table — not a contractor preference — is why a slide or swing gate typically arrives with at least two photo-eye or contact sensors per direction of travel.

How many entrapment sensors does your gate type need?

Minimum independent means required, straight from UL 325 Table 32.2 — not a suggestion.

2 opening / 2 closing
Note

Source: UL 325 Table 32.2, reprinted in DASMA TDS 353. All external means must be monitored every cycle; activation controls must be at least 6 ft from the gate. Not a substitute for the operator manufacturer’s own instructions.

Metal gate frame being fitted against a brick wall
Fitting a metal gate frame against a brick wall — the fabrication/repair step in the sequence above.
Installer holding boxed gate hardware beside a metal gate
Gate hardware staged beside the gate frame before installation.
Ornamental iron gate set into a brick wall
The same gate, finished and set into the brick wall.
Chain link fence and gate across a residential driveway
A finished double swing gate across a residential driveway.

What extends the timeline

A few things reliably add time to a project: needing an electrician to run new service to the gate location, especially if that means trenching under a driveway; discovering during the site visit that posts or the existing gate structure need reinforcement or replacement; permit/plan review time where required; and larger commercial projects with multiple access-credential types (keypad plus telephone entry plus card/fob access, for example).

Outdoor concrete and electrical work is also weather-dependent, and Gulf Coast rain patterns — along with tighter contractor scheduling during hurricane season — can shift installation dates. Building in some flexibility, especially for projects that involve setting new posts in concrete, is a realistic expectation rather than a sign anything has gone wrong.

★★★★★
Very professional and friendly. Gotten automatic gates done and they are done to perfection! Thank you
Tannia Cravinas · Google review · a year ago
★★★★★
We just installed iron gate and it looks amazing thank you very much mustang fencing .
Jordan Carrillo · Google review · a year ago
★★★★★
True professionalism is very rare in this day and age, these guys live upto their word and deliver on their service! Our fence was down in the July storm and these guys came and gave a reasonable quote, after confirming I received a time line and they delivered! Will recommend them to everyone I know who needs fencing done.
Adam Evans · Google review · a year ago

Reviews shown word for word from the Mustang Fencing Services Google Business Profile (Galveston), captured 2026-10-12.

Questions we get about this

What’s the fastest type of automatic gate project?
Retrofitting an operator onto an existing, structurally sound single swing gate is typically the quickest path to automation.
Why do sliding gates usually take longer to install than swing gates?
They often require a track or cantilever arm, a longer clear run of fence line, and more precise alignment than a swing gate’s hinge-and-arm setup.
Does concrete curing time affect the schedule?
Yes — if new posts are set in concrete, the concrete needs to cure before the operator can be mounted and put into full use.
How many safety sensors does my gate need?
Per UL 325 Table 32.2, most gate types need at least 2 independent, monitored entrapment-protection means in each direction of travel (opening and closing); a vertical lift gate needs 1 for opening and 2 for closing. See the tool above for your gate type.
Does Galveston require a permit or code compliance for automatic gates?
The City has adopted the 2021 IRC Appendix AO (Ordinance No. 23-012), which requires automatic vehicular gates to be built to ASTM F2200 and the gate opener to be listed to UL 325.
